01 — Context

The problem.

Four carriers, four portals, four different status vocabularies and four different ideas of what a delivery date means. Operations kept a spreadsheet to bridge them, rebuilt once a day, which meant a consignment could sit stuck for 20 hours before anyone noticed. On-time-in-full was reported at 88.9% but calculated from carrier self-reporting, so nobody quite trusted it.

The commercial cost was concentrated in a small number of lanes and a small number of accounts — but with the data fragmented, nobody could prove which.

02 — Method

The approach.

The build, in the order it happened.

  1. One consignment spine

    A single conforming table keyed on the internal consignment ID, with carrier references as attributes. Every carrier’s status vocabulary maps into one nine-state model agreed with the ops managers, and unmappable statuses raise an alert instead of defaulting to “in transit”.

  2. Incremental ingestion every ten minutes

    Azure Data Factory pulls each carrier feed on a ten-minute cadence with watermark-based incremental loads and a dead-letter table for rows that fail validation. Two of the four had no API, so those are driven by a scheduled Python job against their export endpoint.

  3. Exceptions defined by dwell, not by status

    A consignment is an exception when it has sat in one state longer than that lane’s 90th-percentile dwell time — so the definition adapts per lane rather than assuming a Rotterdam trunk behaves like a Cork city delivery.

  4. Built for a wall, then for a desk

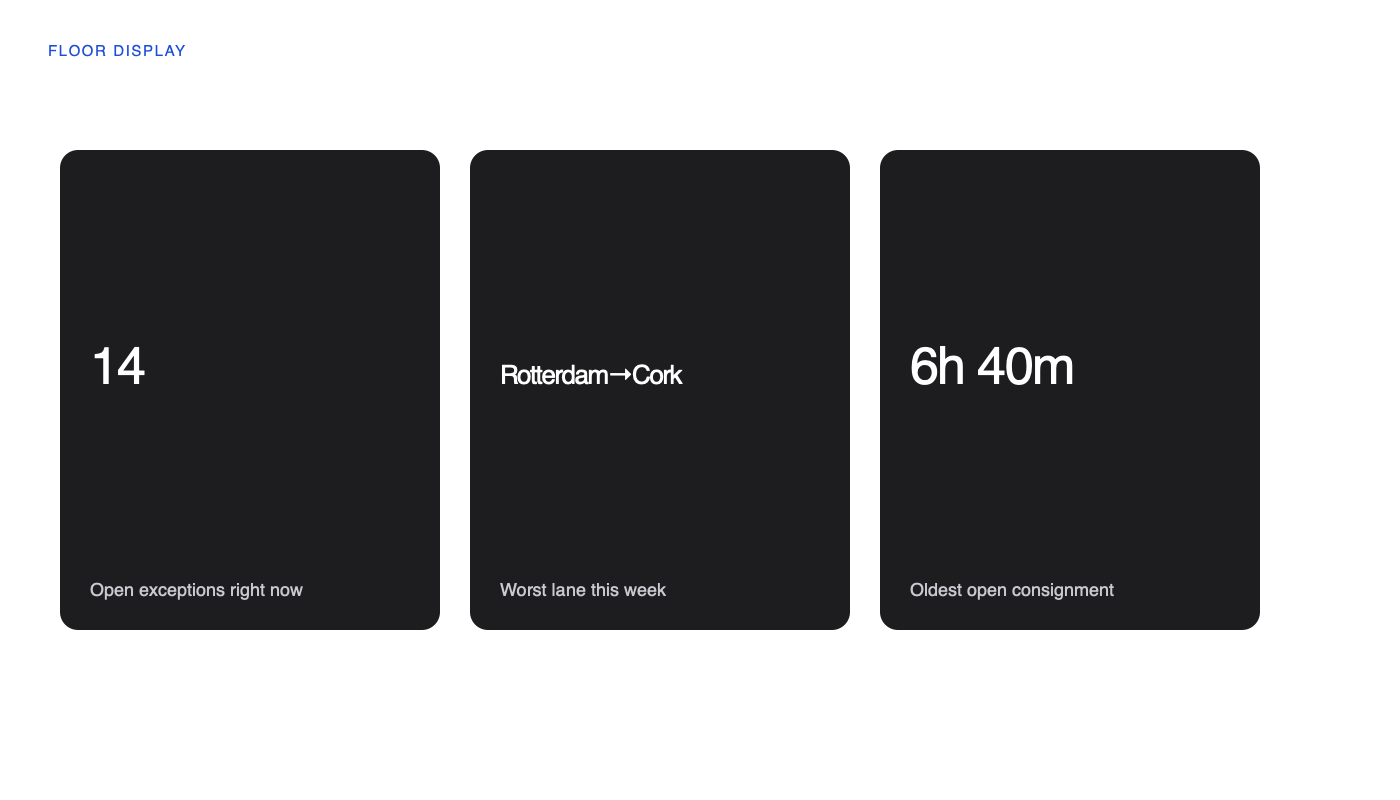

    The primary view is a floor display: exception count, worst lanes, oldest consignment. The analytical drill-down for account reviews sits behind it, sharing exactly the same measures.

03 — Outcome

What changed.

  • On-time-in-full rose from 88.9% to 98.3% over two quarters — the first reconciled week came out level with the carrier-reported baseline, so the gain is not an artefact of the new measure.
  • Data latency fell from a 24-hour spreadsheet cycle to 11 minutes end to end.

  • Two lanes were shown to generate 61% of all exceptions; renegotiating one carrier’s cut-off time removed most of them.
  • Customer-raised exception queries fell by roughly half, because operations now make the call first.

04 — Before & after

The same measures, either side of the work.

Each pair is scaled against its own larger value, so the comparison is honest rather than flattering.

On-time-in-full delivery

+10.6%
Before
88.9 %
After
98.3 %

End-to-end data latency

−99.2%
Before
1440 minutes
After
11 minutes

Carrier systems to reconcile by hand

−75%
Before
4 systems
After
1 systems

05 — The numbers

On-time-in-full delivery.

Tracked as % OTIF, from Wk 1 through Wk 19 — low 88.9, high 98.3.

RouteWatch — On-time-in-full delivery, % OTIF, 2026.

07 — Stack & role

Built with.

  • Power BI
  • SQL Server
  • Azure Data Factory
  • Azure SQL
  • Python
Role
Consulting analyst — data model, ingestion, dashboard, floor rollout
Duration
10 weeks
Client
3PL operator, Cork & Rotterdam
Period
2026

08 — Questions

The questions I get asked about this one.

Two of the four carriers only publish updates in batches anyway, so sub-minute polling would have bought latency the source data does not have. Ten minutes is comfortably inside the window in which an operator can still act.

It lands in the dead-letter table and raises an alert. Defaulting an unknown status to “in transit” is how a stuck consignment stays invisible, so the model refuses to guess.
